Organize delivery with workstreams

Use a durable layer between projects and tasks to improve estimates, time entry, reporting, and delivery decisions.

WhoWorked editorial team5 min read

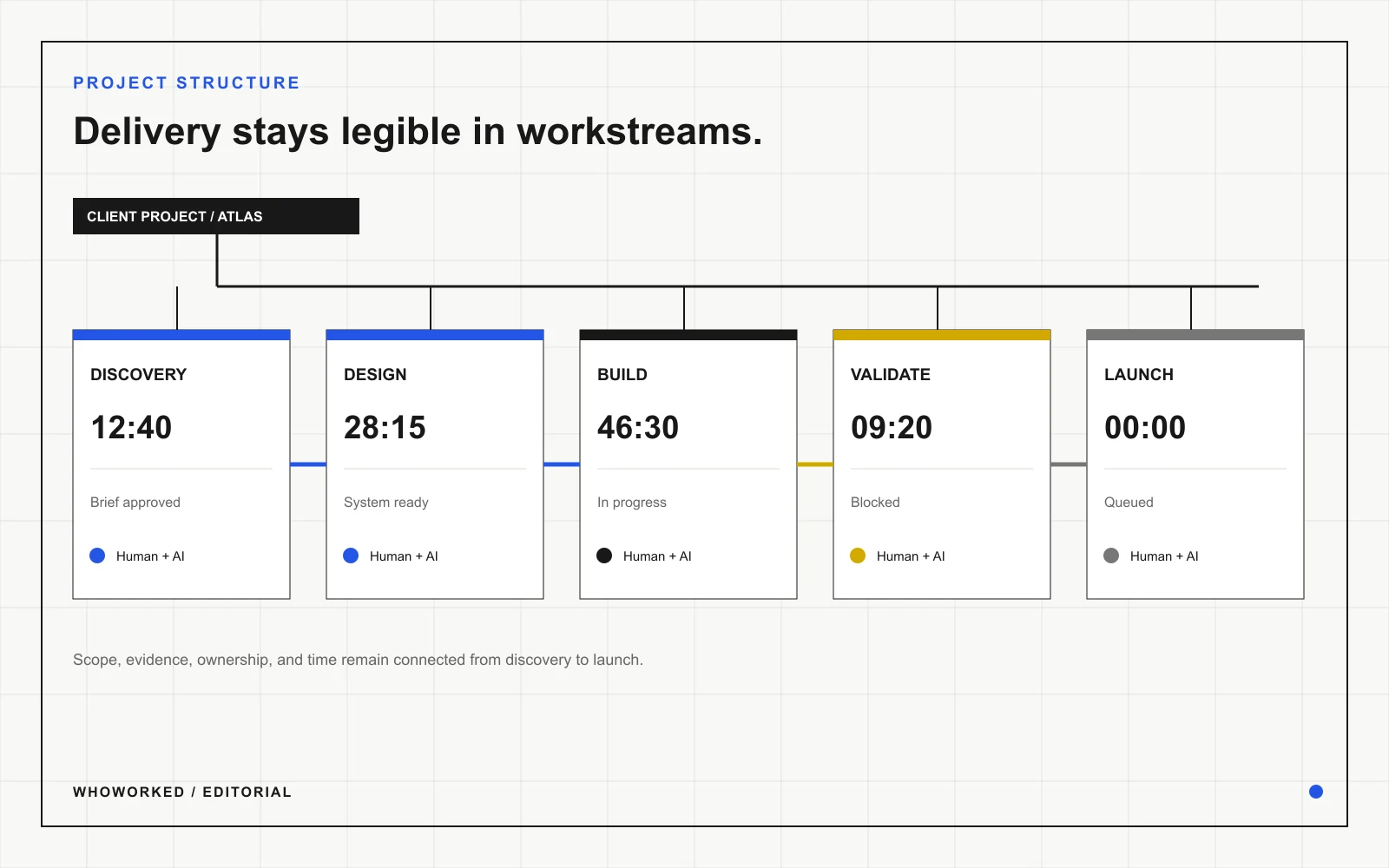

A WhoWorked project organized into research, design, implementation, and quality workstreams

A project tells you where work belongs. It does not always tell you what kind of work is consuming time. One website launch may contain research, content, design, implementation, quality assurance, and client coordination. Workstreams add that missing structure without forcing the timesheet to copy every ticket or activity from another tool.

What a workstream is

A workstream is a durable category of effort inside a project. It groups related time entries around a recognizable part of delivery. Workstreams are specific enough to support planning and reporting, but broad enough to remain stable while tasks, documents, and individual assignments change.

Think of a workstream as the answer to a practical question: what part of the project moved forward? Research is a workstream. Checkout implementation is a workstream when it represents a meaningful delivery area. Answering email is not usually a workstream because it describes an activity rather than an outcome area.

Why projects need a middle layer

Project-only reporting hides the shape of delivery. A project may be on budget overall while quality assurance is consuming twice the expected effort and design is underused. By the time the total crosses a warning threshold, the team has lost several chances to respond.

Task-level reporting creates the opposite problem. Backlogs contain hundreds of items, naming changes over time, and different teams use different levels of detail. Reports become difficult to compare, and people spend more time locating the perfect code than recording accurate time.

Workstreams create a consistent lens between those extremes. The project remains the commercial container. Tasks remain the execution plan. The workstream becomes the reporting structure used for estimates, capacity, time entry, and review.

Design a useful set of workstreams

Start with how your team already discusses delivery. Review recent proposals, project plans, and budget conversations. Collect the recurring categories, then reduce overlap. Strategy and discovery may be separate for one agency and a single workstream for another. The right model reflects decisions your team genuinely makes.

Keep the first version small. Five to nine workstreams are enough for many projects. Too many choices slow time entry and produce inconsistent classification. Add a workstream only when it represents a meaningful budget, staffing, or reporting distinction that existing categories cannot answer.

  • Use nouns that describe delivery areas: research, content, design, implementation, quality assurance, project leadership.
  • Avoid status labels such as planned, in progress, or blocked. Status belongs to the work item, not the workstream.
  • Avoid naming a workstream after one person or tool. Ownership and tooling change more often than the underlying delivery area.

Write one-line boundaries

For each workstream, write a one-line description and two examples. The description should explain what belongs there; examples remove ambiguity at entry time. For quality assurance, you might include test planning, manual verification, and defect reproduction, while excluding implementation of the fix itself.

Also document the closest alternative. Teams hesitate when an entry could fit two labels, such as research and strategy or implementation and quality assurance. A short boundary rule is more useful than a detailed taxonomy that nobody remembers during a busy afternoon.

workstream-definition.txt
Research: evidence gathering that reduces uncertainty before a delivery decision.
Includes: interviews, analytics review, competitive review.
Use Strategy instead when: the work turns evidence into a recommended direction or plan.

Connect estimates and actual time

Workstreams become valuable when the same structure appears in planning and reporting. Estimate effort by workstream before delivery begins, then record actual time against those same labels. This creates a direct comparison without retroactively translating task lists into budget categories.

Review variance while the project is active. If research is complete under budget but implementation is rising quickly, the team can adjust scope, staffing, or expectations. The purpose is not to punish imperfect estimates. It is to expose changed assumptions early enough to make a useful decision.

Use one structure for human and AI work

Do not create a generic AI workstream. AI is a method of contribution, not usually the project outcome. An AI-assisted synthesis belongs in research; generated test cases belong in quality assurance; a drafted launch email belongs in content. Record material AI involvement separately while preserving the delivery category.

This makes before-and-after comparisons possible. The team can see whether human time in a workstream changed after adopting AI without breaking the historical series. It also keeps client reports focused on delivered work while supporting responsible attribution behind the report.

Roll out the model with real entries

Pilot the workstreams on one active project for two weeks. Ask the team where classification felt obvious, where it felt ambiguous, and which labels did not support a real decision. Review a sample of entries together. Rename or merge categories before expanding the model across the workspace.

Once adopted, resist frequent changes. A stable model creates trend data and shared language. Review it quarterly or when the delivery model changes materially, not whenever one unusual task appears. Exceptional work can still be described in the entry note without creating a permanent category.

Good workstreams make time tracking easier because people choose from a small set of meaningful delivery areas. They make reports stronger because estimates, actuals, human effort, and AI involvement share the same structure. Start from the decisions your team needs to make, keep the model stable, and let task details stay in the tools built for tasks.
